Change Management in SAP S/4HANA Programs: What to Plan Before Go-Live

Explore how to prepare your organization for SAP S/4HANA go-live with effective change management, role-based training, user adoption planning, and readiness assessments.

An SAP S/4HANA implementation changes more than the systems employees use. It can affect how purchase orders are approved, financial transactions are posted, inventory is managed, and information moves between departments. Even when the technology is ready, employees may struggle with unfamiliar workflows, revised responsibilities, or processes that no longer work as they did in the previous ERP environment.

These challenges need attention long before go-live. Organizational change management (OCM) helps companies identify who will be affected, prepare teams for new ways of working, and maintain business continuity as employees transition to SAP S/4HANA.

Quick answer: Before an SAP S/4HANA go-live, organizations should complete a role-level change impact assessment, establish executive sponsorship and business ownership, prepare a stakeholder communication plan, organize role-based training, build a user support network, and define measurable readiness and adoption criteria. These activities should follow the implementation schedule, with clear responsibilities assigned to internal teams and the SAP implementation partner.

What Is Change Management in an SAP S/4HANA Program?

SAP S/4HANA change management is the structured process of preparing employees, managers, and business functions to adopt the processes, responsibilities, and working practices introduced by a new ERP environment.

It addresses the organizational consequences of the implementation, from changes in approval authority to the adoption of SAP Fiori applications and redesigned business workflows.

Organizational change management is different from technical change control. Technical change control governs modifications to system configurations, developments, and other technical components. OCM focuses on how people understand, accept, and use the resulting changes.

It is also broader than end-user training. Employees may know how to complete a transaction in SAP S/4HANA without understanding why the process has changed, who now owns an approval, or how exceptions should be handled.

In an SAP program, OCM typically covers four connected areas:

  • Change strategy and stakeholder engagement: Identifying affected groups, securing leadership involvement, and addressing concerns about the transition.
  • Change communication: Explaining upcoming process changes, their rationale, and what different employee groups need to do.
  • User enablement: Preparing employees through training, practice, documentation, and local support.
  • Change effectiveness: Assessing organizational readiness and measuring how employees use the new processes after go-live.

SAP addresses these activities through its organizational change management guidance and the Solution Adoption workstream of SAP Activate. The specific activities and resources vary by implementation scenario, but the goal is to prepare business teams to work effectively in SAP S/4HANA.

Why Does Change Management Matter During an SAP S/4HANA Implementation?

A technically successful implementation does not automatically produce the operational improvements identified in the business case. Those improvements depend on employees performing their work effectively in the new environment.

Consider a manufacturing company moving from SAP ECC to SAP S/4HANA. Its procurement team may encounter revised approval workflows, new application interfaces, and different exception-handling procedures. If employees continue relying on old instructions or informal workarounds, the company may experience delayed approvals, additional support requests, and inconsistent process execution.

Similar problems can affect financial close, order fulfillment, warehouse operations, and production planning.

The risk is especially significant when the transformation includes process standardization. A company introducing common workflows across several plants or countries may encounter resistance from teams accustomed to local procedures. Some objections may reflect a preference for familiar practices, while others may reveal legitimate regulatory, operational, or integration requirements that the target design has overlooked.

Change management helps distinguish between these situations before they disrupt operations.

Research also supports investing in structured change activities. In Prosci's change management benchmarking research, 88% of respondents who rated their change management as excellent reported meeting or exceeding project objectives, compared with 13% of those reporting poor change management. The findings cover different types of organizational projects and establish a correlation rather than an SAP-specific success rate.

For SAP S/4HANA programs, the practical implication is that user readiness deserves the same planning discipline as system testing, data migration, and cutover preparation.

What Should an SAP S/4HANA Change Impact Assessment Cover?

A change impact assessment identifies how the future SAP S/4HANA environment will affect specific business roles, processes, responsibilities, and working practices.

The assessment should begin while the target processes are being designed. Waiting until training development starts leaves too little time to address significant organizational changes.

Identify changes at the role and process level

An SAP module-based assessment alone may overlook changes that affect employees across multiple processes and applications. A single business role may interact with several modules and applications, while two employees using the same module may experience very different changes.

For example, an accounts payable specialist might need to learn a revised invoice-processing workflow, while the finance manager may face new approval responsibilities and reporting procedures. Both belong to the finance function, but they require different communications, training, and readiness checks.

For each affected role, document the current process, the future workflow, changes in responsibilities, required skills, and dependencies on other teams. Include changes to authorizations and segregation of duties where relevant.

This provides the foundation for estimating the effort needed to prepare each user group.

Classify impacts by type and business criticality

Change impacts can be grouped into four practical categories.

Process impacts concern how tasks are performed, including additional steps, removed activities, revised approval sequences, and new exception procedures.

Role and responsibility impacts concern who performs, reviews, or approves work. These changes may require updated job descriptions, operating procedures, or authorization assignments.

Technology and interface impacts concern how employees interact with SAP S/4HANA, SAP Fiori, and connected applications.

Organizational impacts concern broader changes, such as centralized services, shared process ownership, or the replacement of local workflows with global standards.

The assessment should also consider the business criticality of each change and the number of affected users. A minor interface adjustment for a large employee group may require different preparation from a fundamental process change affecting a small team responsible for critical financial controls.

The output should be an actionable impact register connected to the communication, training, testing, and deployment plans.

How Should Organizations Manage Executive Sponsorship and Employee Resistance?

Executive sponsorship gives organizational change management the authority to make decisions that individual project teams cannot make.

An effective sponsor explains the business rationale for the transformation, supports process owners when established practices are challenged, and helps remove organizational barriers to adoption.

However, one executive cannot manage employee readiness across an enterprise. Business process owners and line managers need defined responsibilities for communicating changes, allocating employees' time to training, and confirming that their teams can perform critical activities.

The implementation partner can facilitate this work, but accountability for business adoption remains with the organization.

Build communication around specific changes

Employees need different information at different stages of an SAP S/4HANA implementation. Early communication should explain why the organization is changing its ERP environment, what business objectives the program supports, and which functions may be affected.

As process designs become clearer, communication should become more practical. A warehouse employee needs to know whether receiving procedures, scanning activities, or inventory adjustments will change. A finance manager needs to understand modifications to controls, approvals, and reporting responsibilities.

Near go-live, communication should prioritize confirmed dates, access requirements, available support, temporary operating arrangements, and escalation routes.

Messages should come from credible business leaders as well as the project team. Employees are more likely to understand the practical significance of a change when their own managers can explain what it means for daily operations.

Treat resistance as information

Employee resistance can reveal problems that are otherwise difficult to identify during system design.

For example, a plant manager may object to replacing a local inventory procedure because it supports a time-sensitive production requirement. The concern may indicate an overlooked business dependency rather than an unwillingness to adopt a standard process.

Change teams should capture such concerns, evaluate them with the relevant process owners, and communicate the decisions made. Some issues may justify a design change. Others can be addressed through clearer instructions, additional practice, or an explanation of why the standardized process is necessary.

This helps teams address legitimate operational concerns while maintaining the agreed target processes.

How Do You Build a User Adoption Plan Before Go-Live?

A user adoption plan connects identified changes with the activities employees need to complete before they begin using SAP S/4HANA in production.

It should follow the actual deployment strategy rather than treating the entire workforce as one training population.

The plan should identify each affected user group, the changes they must adopt, the activities needed to prepare them, and the people responsible for delivery. It should also specify training and communication milestones, readiness criteria, support arrangements, and the measures used to evaluate adoption. This gives each change management activity a clear owner, deadline, and expected outcome.

Align adoption activities with rollout waves

A company deploying SAP S/4HANA across multiple locations may introduce the system in phases. Each wave can involve different processes, languages, regulations, working practices, and employee groups.

The change impact assessment should therefore be reviewed for each wave, even when the technical solution follows a common template.

A standardized process may still require different preparation in a distribution center, manufacturing plant, and shared services organization.

This is particularly relevant to global transformation programs where centrally designed processes must accommodate local operating requirements.

Establish a network of business super-users

Super-users are employees who develop deeper knowledge of the new system and help colleagues prepare for the transition.

They can participate in process walkthroughs, provide feedback during testing, identify gaps in learning materials, and offer practical assistance during the initial production period.

Their value comes partly from business knowledge. An experienced warehouse supervisor, for example, can explain a new goods receipt process in the context of actual warehouse operations.

Super-users need protected time for preparation and support activities. Assigning the role without adjusting their normal workload risks leaving them unavailable when colleagues need assistance.

The appropriate network size depends on transaction complexity, user distribution, working shifts, language requirements, and expected support demand. A fixed ratio of super-users to employees should not replace this assessment.

When should change management activities take place in SAP Activate?

Change management activities should follow the implementation lifecycle rather than begin shortly before deployment. SAP Activate addresses organizational change management through its Solution Adoption workstream, with activities spanning multiple project phases.

During Discover, organizations can begin defining the scope of organizational change and the resources needed to support it. During Prepare and Explore, teams establish the change strategy, identify affected stakeholders, and assess the organizational impact of future processes. In Realize, they develop training materials, prepare super-users, and refine communication and adoption plans as the configured solution takes shape. Deploy focuses on confirming user readiness, completing training, and preparing support arrangements. After go-live, the Run phase involves monitoring adoption, addressing remaining capability gaps, and transitioning to ongoing support.

The sequence may differ by implementation scenario, but user preparation should advance alongside system delivery.

How does SAP Activate guide an SAP S/4HANA implementation?
Explore the phases, key deliverables, and quality gates of SAP Activate, and learn how the methodology helps teams coordinate implementation activities, manage project risks, and prepare for go-live.

What Makes an SAP S/4HANA End-User Training Strategy Effective?

Effective SAP S/4HANA training prepares employees to perform their assigned business processes, including routine transactions and the exceptions they are likely to encounter.

A generic introduction to system navigation can be useful, but it cannot replace instruction based on the organization's configured workflows.

Design learning paths around business tasks

Training requirements should reflect what employees actually do. An accounts payable specialist may need to process invoices, investigate blocked documents, and follow revised approval procedures. A warehouse operator may need to perform goods movements using the applications, devices, and scanning processes available at the site. These groups require different exercises, even if both are part of the same implementation.

Learning paths can combine instructor-led sessions, guided system practice, short reference materials, and self-paced content. The combination should reflect the complexity and frequency of the tasks involved.

Employees performing infrequent but business-critical activities may need additional reference materials because they have fewer opportunities to practice.

Schedule training against system readiness and cutover

Training delivered too early may become outdated due to configuration changes. Training delivered immediately before go-live leaves little opportunity to address knowledge gaps.

A more practical approach is to introduce general concepts earlier, then deliver task-specific practice once the relevant workflows are sufficiently stable.

Training schedules should leave time for employees who miss sessions, struggle with critical procedures, or require additional practice.

User acceptance testing (UAT) can support this process by exposing selected business representatives to realistic scenarios. However, UAT and training have different objectives. UAT establishes whether the solution supports agreed business requirements; training prepares the broader workforce to use it. Participation in one does not automatically replace the other.

Verify whether employees can perform critical tasks

Training effectiveness should be assessed through practical exercises, not attendance records alone. Employees in critical roles should demonstrate that they can complete representative business transactions, including relevant exceptions, in a suitable practice environment.

Assessment results help identify employees who need additional instruction, practice, or guidance. Any unresolved capability gaps should be documented and passed to the organizational readiness review.

How Do You Assess Organizational Readiness Before SAP S/4HANA Go-Live?

Organizational readiness determines whether employees and business functions are prepared to operate under the new processes when SAP S/4HANA enters production.

This assessment complements technical go-live readiness. A system may pass integration tests and data reconciliation while a critical business team remains unable to perform its required activities.

A useful organizational readiness review examines five areas.

Readiness area

Evidence to review

Business ownership

Named process owners, confirmed responsibilities, and operational sign-offs

Process preparedness

Approved procedures, resolved critical role impacts, and documented exception handling

User capability

Training completion, practical assessments, and remediation of critical gaps

Operational communication

Confirmed go-live instructions, business contacts, and escalation routes

Support preparedness

Super-user availability, service desk procedures, and hypercare coverage

Readiness gaps should be assessed based on their impact on critical business operations, the availability of temporary workarounds, and the organization's ability to resolve them. Each issue needs a documented owner and an agreed response before the final go/no-go decision.

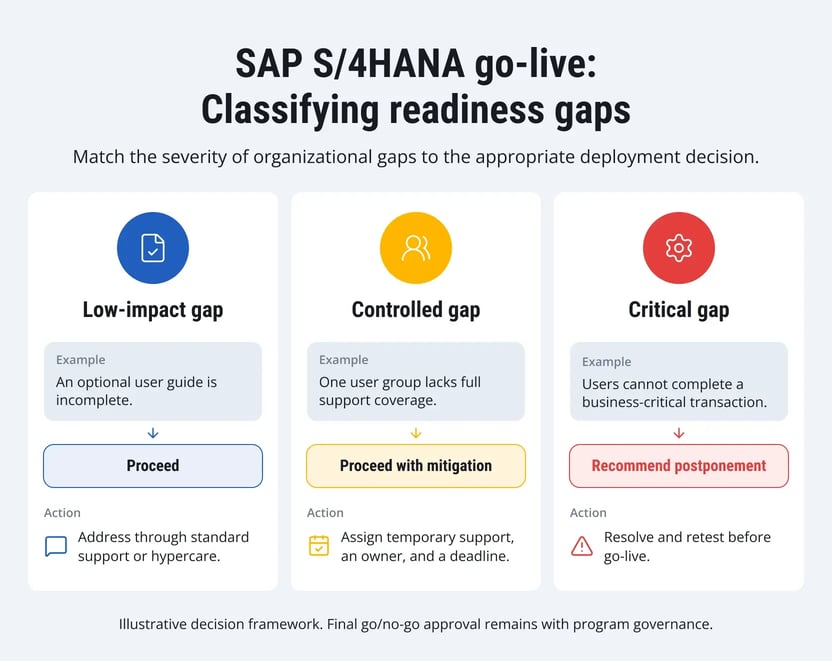

The following framework illustrates how different levels of organizational risk can influence deployment decisions.

sap-s4hana-change-management-1

Organizational readiness should inform the overall go/no-go recommendation. The final decision belongs to the designated business governance body and must consider technical, operational, compliance, and business continuity risks together.

Organizational readiness reviews should follow the implementation schedule, with key decisions aligned to SAP Activate phase milestones and relevant quality gates rather than a fixed monthly meeting cycle. This helps business leaders assess adoption risks when they can still influence deployment decisions.

How can effective governance keep a multi-year SAP program on track?
Explore how defined decision rights, steering committees, quality gates, and escalation paths help organizations manage risks, maintain accountability, and make informed go/no-go decisions throughout an SAP transformation.

Which KPIs Measure SAP S/4HANA Adoption After Go-Live?

Adoption measurement shows whether employees are using the new processes effectively and where additional intervention is needed.

Organizations should distinguish three dimensions: whether employees are using the intended solution, whether they can complete their work correctly, and whether performance is moving toward the expected business outcomes.

Useful measures include:

  • Process utilization: Whether relevant users perform designated activities through the intended SAP S/4HANA workflows rather than unauthorized workarounds.
  • Task completion and error rates: The percentage of selected transactions completed correctly, including rework and failed attempts where these can be measured reliably.
  • Process cycle time: The time required to complete business activities such as invoice approval or goods receipt, compared with an appropriate baseline.
  • Support demand: The volume, type, severity, and resolution time of user issues.
  • User proficiency: Results from practical assessments and follow-up evaluations for critical roles.

Adoption indicators should not be treated as a substitute for business outcomes. Employees may use the new system consistently while process cycle times, error rates, or operating costs remain unchanged. Reviewing adoption metrics alongside the business KPIs defined in the transformation case helps determine whether further improvements are needed in user capabilities, process design, or the solution itself.

Measures should reflect the processes affected by the implementation. A finance transformation may prioritize invoice-processing accuracy and financial close activities, while a warehouse deployment may prioritize goods-movement accuracy and operational throughput.

Collect baseline data before go-live where comparable information is available. When workflows change substantially, establish how old and new measures will be compared rather than assuming the figures represent identical activities.

Use hypercare to turn measurement into action

Hypercare is the period of enhanced support immediately following production deployment. It brings business representatives, functional consultants, technical specialists, and support teams together to address early operational issues.

Support requests should be classified by their underlying cause. A user who cannot find the correct application may need additional guidance. A transaction that repeatedly fails because of authorization settings requires a different response.

Not every reported problem is a training issue. Some may arise from master data, configuration, integrations, process design, or unclear responsibilities.

Organizations should review adoption and operational indicators during hypercare and adjust support accordingly.

The transition to normal support should depend on agreed exit criteria, such as resolution of critical incidents, stable execution of priority processes, documented ownership of remaining issues, and adequate support-team readiness.

What Should an SAP Implementation Partner Contribute to Change Management?

An SAP implementation partner can provide the methodology, expertise, and resources needed to organize change management activities throughout the project. Depending on the engagement scope, these may include change impact assessments, training development and delivery, super-user enablement, and adoption measurement.

Before signing the statement of work, organizations should agree on who will develop communications, prepare training materials, deliver training, coordinate super-users, and provide post-go-live support. Responsibilities should be clearly assigned, particularly when several business functions, local project teams, or external providers are involved.

Deliverables should be supported by acceptance criteria and dates. For example, a commitment to provide user training is less useful than an agreed curriculum, defined user groups, specified delivery responsibilities, and a documented process for remediating readiness gaps.

Prospective partners should also be able to show how their change activities connect to process design, testing, deployment, and ongoing support.

For SAP S/4HANA Cloud programs delivered through RISE with SAP, the division of responsibilities should also account for the subscription's service and support model. Organizations need to clarify which change management and user enablement activities remain with internal teams, which are assigned to the implementation partner, and how these arrangements fit into post-go-live support.

What should you ask an SAP implementation partner before signing a contract?
Learn which questions can help you evaluate a partner's delivery experience, implementation methodology, governance approach, and ability to manage project risks before committing to an SAP transformation.

How LeverX supports SAP S/4HANA change management

LeverX combines SAP implementation expertise with practical experience managing the organizational side of ERP transformations. Our work with Eurasia Group Kazakhstan shows how close collaboration between implementation teams and business stakeholders can support a structured transition to SAP S/4HANA.

LeverX experience: managing organizational change during SAP S/4HANA migration

LeverX supported Eurasia Group Kazakhstan's migration from SAP ECC to SAP S/4HANA, working alongside 25 client specialists to complete the project in 8.5 months. The teams used SAP Activate to structure the implementation, with the client actively involved in requirements alignment, testing, organizational change management, and end-user preparation. Key activities included stakeholder communication planning, key-user training, and the development of user manuals and training materials.

The migration also delivered measurable improvements, including a 15% increase in data consistency and a 10% reduction in system maintenance costs. While these results reflect the broader SAP S/4HANA transformation, the project provides a practical example of how customer involvement in organizational change management can accompany technical implementation.

Conclusion

SAP S/4HANA go-live readiness depends on employees being able to execute the processes their business relies on. Identifying changes early, involving process owners, providing practical training, and measuring adoption give organizations a clearer basis for deployment decisions.

Start with a role-level change impact assessment and use its findings to scope the communications, training, readiness checks, and support needed for a controlled transition.

FAQ

How does change management differ between an SAP S/4HANA new implementation and a system conversion?
A new implementation often introduces redesigned workflows, new responsibilities, and broader process standardization, requiring extensive communication and user preparation. A system conversion may preserve more existing processes, but changes to applications, authorizations, custom transactions, and business procedures can still affect employees. In both scenarios, the scope of change management should reflect the actual impact on business roles rather than the technical migration approach alone.
How do you assess a partner's SAP implementation methodology before you sign?
Ask how organizational change management fits into the partner's methodology and what evidence demonstrates its effectiveness. Review sample change impact assessments, training deliverables, and readiness reports from comparable projects. Check how adoption risks are escalated, who validates organizational readiness, and whether change management activities are integrated into project quality gates rather than managed separately.
What should organizations do if critical users are not ready for SAP S/4HANA go-live?
Identify which business processes are affected and determine whether employees can perform essential tasks safely and accurately. Address gaps through additional training, practical assessments, or targeted support. If critical activities cannot be performed reliably and no acceptable workaround exists, escalate the issue through the readiness governance process and consider postponing the affected deployment. The final decision should reflect business continuity, compliance, and operational risks.
Who owns quality assurance when the program runs on SAP's own methodology?
SAP Activate provides a structured implementation framework, but organizational change deliverables still require defined review and acceptance responsibilities. The implementation partner may prepare evidence, while business process owners, the PMO, or an independent assurance team validate different aspects of readiness. The program's governance arrangements should specify who reviews the evidence, approves exceptions, and authorizes progression through relevant quality gates.
https://leverx.com/blog/sap-s4hana-change-management
content.id: 224255506200
table_data_hubl: []

How useful was this article?

Thanks for your feedback!

5
0 reviews
Don't miss out on valuable insights and trends from the tech world
Subscribe to our newsletter.

Body-1
